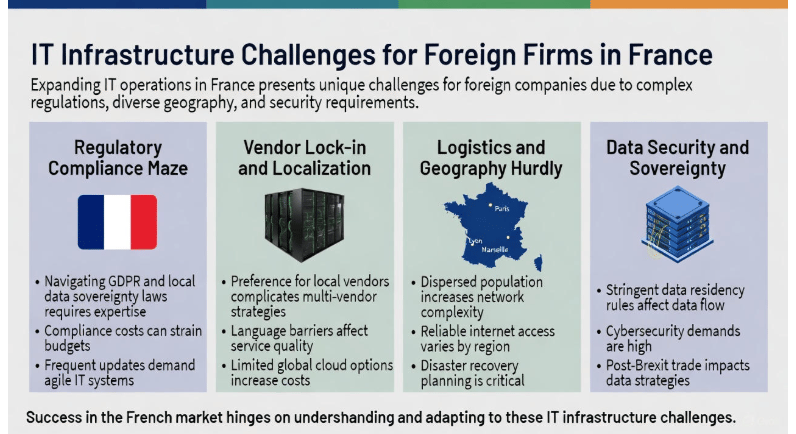

Overcoming IT Infrastructure

Expanding IT operations in France presents unique challenges for foreign companies due to complex regulations, diverse geography, and security requirements.

7 min read

Expanding IT operations in France presents unique challenges for foreign companies due to complex regulations, diverse geography, and security requirements.

Regulatory Maze

  • Navigating GDPR and local data sovereignty laws requires expertise.

  • Compliance costs can strain budgets.

  • Frequent updates demand agile IT systems.

Vendor Lock-In and Localization

A Guide to Server Rack Sizes for Data Centers

  • Preference for local vendors complicates multi-vendor strategies.

  • Language barriers affect service quality.

  • Limited global cloud options increase costs.

Geography Hurdle

France | History, Maps, Flag, Population, Cities, Capital, & Facts ...

  • A dispersed population increases network complexity.

  • Reliable internet access varies by region.

  • Disaster recovery planning is critical.

Data Sovereignty and Security

What is Sovereign Cloud? Ensuring Data Sovereignty and Security ...

  • Stringent data residency rules affect data flow.

  • Cybersecurity demands protection against threats.

  • Post-Brexit trade impacts data strategies.

Success in the French market hinges on understanding and adapting to these IT infrastructure challenges.

The growth of any company in France does introduce gigantic opportunities

A single market of 68 million consumers, a logistics center in the world in Paris, Lyon, Marseille, and others. However, the paths of IT infrastructure are never that smooth for the firms who are not in the EU, not to mention the current post-Brexit United Kingdom. Data sovereignty policies, language obstacles, demanding multifaceted enabling procedures, and unexpectedly disjointed vendor markets make what appears to be a straightforward store or office deployment, a six- to eighteen-month nightmare. In that respect, this guide elaborates on the most typical challenges and therefore provides battle tested solutions that can be implemented immediately by the executives.

The Regulatory Maze: GDPR is not the Only Thing

The vast majority of the executives have heard of the General Data Protection Regulation, yet not many realize how potent it is when it comes to making physical IT infrastructure decisions in France. Article 32 of GDPR requires that organisations consider the introduction of appropriate technical and organisational mechanisms to protect personal data, and the French data protection authority

has always understood this to imply that some types of sensitive data would remain in the EU whenever feasible. To non-EU firms, that puts them in an immediate quandary: Do you continue to route European customer traffic via your London, Virginia, or Singapore data centers, or do you localise?

Practically, the way forward that most retailers and mid-sized businesses are currently pursuing is to locate their customer-facing applications, like e-commerce platforms, loyalty databases, and CCTV analytics, in the EU. The attractive location by itself is France, which is incredibly competitive in electricity prices (among the lowest in Europe, thanks to the nuclear production) and an increasing number of hyperscale and colocation sites in Paris, Marseille, and, soon, in the Grand Est.

But the effect of localization is a series of secondary needs

Any new structured cabling and active equipment in a leased retail or office space should comply with the French building codes, namely, NF C 15-100 on electrical installations, and European Low Voltage Directive.

When designing an APSAD R4 ruleset, gases should be selected to suppress fire in server rooms or other IT closets.

The cloud or managed service provider which handles your personal data must sign a Data Processing Agreement meeting the requirements of Article 28 expressly; in many cases, it is necessary to negotiate the same in French.

The penalties on non-compliance are significant enough in cash--CNIL has fined EUR280 million in 2024 alone--but the bigger danger is time: one certificate missing can postpone the opening of a store by months.

Localization of Vendors and the French Exception

Although the regulatory questions have been resolved, the foreign executives continue to underestimate the fragmentation of the French telecoms and integration market on a regular basis. In contrast to the UK or Germany, with a small number of national players (BT, Vodafone, Deutsche Telekom) dominant in the enterprise fiber and integration offering, France still has hundreds of local installation firms - many of them family-owned - who are the ones that have the

relationships to building syndics, city permitting offices, and the influential French electrical inspectors (Consuel).

The global players, such as Orange Business Services, Colt, or SFR Business, can possibly offer carrier-grade connectivity directly, however, they tend to outsource the final 100 meters of fiber optic pulling and rack-and-stack operations to these domestic players. and should you attempt to bypass them to import your own British or American cabling crews, you will certainly run into a wall: work permits, obligatory safety qualifications (Habilitation Electrique), and trade regulations will do all but make it impossible.

The result? Lead times that would otherwise be measured in weeks are measured in months in France. When a retail chain goes out and opens ten stores at once, it can readily find itself waiting on ten local subcontractors, with their individual holiday schedules and backlog.

Logistics/ Geography: Paris Is Not France

The head offices and data are still gravitated in Paris. There are over 120 facilities within the Paris region that most companies prefer secondary cities because of the cost or the proximity to customers. Greater Lyon can charge 30-40% less than Paris on colocation, and Marseille has become the main Mediterranean port of landing submarine cables linking Europe to Asia, Africa, and the Middle East. Marseille is the location that is touched upon by all new 2Africa, SeaMeWe-6, and Medusa cables, and this makes it a latency hotspot for companies with operations operating on multiple continents.

However, in the wake of Brexit, the transit of equipment between the UK or northern Europe to southern France implies this would be cleared at Calais or Dunkerque, VAT deferment documentation, and can be inspected. A EUR.1 movement certificate is missing, and a EUR200,000 switch shipment will not be realized after several days, multiplied by dozens of sites, the cost quickly becomes considerable.

Developing a Resilient Deployment Model.

Effective foreign entrants follow a three layer deployment strategy

  1. National Partnership of Carrying Nativism

Sign a framework deal with one of the main three (Orange, SFR, Bouygues) or international players such as Colt or Zayo regarding MPLS/SD-WAN and Internet breakout. With these contracts, you have predictable prices and SLAs in the entire country.

  1. Remote Hands and Integration Partner in the Region

Rather than having to deal with twenty local subcontractors in each area of operation individually, deal with a single national integrator who has already the licenses, insurance, and contacts in the different departments. These partners will be able to supply certified remote-hand engineers that may take shipments, assembly rack equipment, cross-connect running, and minimal troubleshooting 24/7. Some of the major competitors are Etix Everywhere, Scaleway (cloud), and specialized concierge businesses such as IT Concierge, Spixi, or Global Net Access.

  1. Edge Architecture + Hybrid Cloud

Put customer-facing requirements on French or European Infrastructure as a Service, including OVHcloud, Scaleway, and Outscale-certified SecNumCloud, and retain your own back-office systems, where required, back home. The positive aspect is that it is transparent to the user in terms of the modern SD-WAN and SASE platforms, and it keeps you right out of the data-sovereignty issues.

Hypothetical Case Study: 25 Stores of a UK Fashion Retailer Open after Brexit.

Take the case of Aurora Fashion PLC, a mid-market chain of clothes stores in Manchester, having 120 outlets in the UK, and intends to expand to Europe aggressively. After Brexit, Aurora plans to establish 25 stores in France within 18 months, with flagships in Paris (Opera), Lyon Part-Dieu, and Marseille Vieux-Port.

Initial Plan (Naive Approach)

The same kit specified by the UK IT team at Aurora is the one used at home: HPE Aruba edge switches, Meraki Wi-Fi, and an MPLS network provided by BT. It will enter direct contract with Orange in the primary fibre and will send their own engineers to the location and spend 2 days installing the main fibre.

Reality Hits Within Weeks

The Marseille city council demanded an archaeological survey and an eight-week delay of Rue Paradis trench work.

The Paris store occupies a Haussmann block belonging to a co-operative syndicate requiring any cabling to be laid in and certified by a Bureau Veritas surveyor in existing goulottes.

At Calais, in case of Brexit, customs clearance will take 4-6 days per switch shipment. It also attracts 20 percent French VAT, which can be claimed back only after several months.

The engineers in the UK find out that their electrical habilitation certificates are not supported in France; they cannot touch any cabinet until a local electrician certifies the work.

Revised Flag-Fraud Deceiving with Victory

Instead of the DIY strategy, Aurora balances with a Paris-based integrator, IT Concierge, where she agrees to a master services contract, which the latter deals with the foreign retail rollouts.

The new playbook

The IT Concierge receives all the equipment in their bonded warehouse near Roissy CDG, does customs clearance, and resorts to regional teams.

Local certified electricians and fiber technicians who are already familiar with the syndics do physical installation under the oversight of the IT Concierge.

In Gravelines (northern France), Aurora changes to e-commerce front-ends based on OVHcloud with automatic geo-fencing that complies with the GDPR.

A French-speaking project manager provides weekly English dashboards to the HQ of Aurora in Manchester.

Outcome: The initial ten stores are operational, budget-wise, and have been initially opened without CNIL exposure. Actually, the Marseille flagship is opened two weeks before, as IT Concierge had agreed with another retail client on the same street.

The 10-Point Action Plan of an Executive Checklist

  • Assign a DPO to France or outsource a DPO as a service firm within 60 days of operation.

  • Decide on your data localization stance before committing to any real estate leases, fully French, EU-wide, or hybrid.

  • Identify two national telephone companies and one remote hands/integration company in the due diligence stage.

  • Budget 25-35 percent high premium on hardware capital expenditure on custom duties and VAT pending reclamation.

  • Demand fixed price, fixed schedule statements of work with your integration partner. French subcontractors will hardly do otherwise.

  • Wherever feasible, make use of containerized or cloud-native applications so that the on-premise footprint is minimized.

  • Plan store opening coincides with French school holidays. On average, B2B services are slower in August and end of December.

  • Before handover, ensure that your integrator supplies Consuel electrical certificates and APSAD fire-suppression attestation.

  • Create a bilingual (English/French) runbook in each site--your UK NOC will owe you at 2 a.m. when one of the access points fails.

  • Get involved at the beginning - half a year before opening the first store - with a kind of concierge partner who already has knowledge of the syndiques, the inspecteurs, and the unwritten regulations.

France is among the most appealing markets in Europe, though limited to the firms that perceive IT infrastructure as a strategic rather than a tactical issue. The victors are the ones that would cease attempting to deploy their home-country playbook and accept local expertise that is specialized. Firms such as IT Concierge, who employ engineers on the ground in all their major cities and have years of relationships with building owners and regulators, turn what was once a nightmare into a process that can be repeated. In a world where a late opening store can cost millions in valuation, that alliance is not a nice to have, it is either European success or a millions-in-retirement own-goal.
